Cabrillo Slow Street

SFMTA.com/CabrilloSlowStreet
Project Introduction

Cabrillo Street from 45th Avenue to 23rd Avenue in the Richmond was approved as a Slow Street by the San Francisco Municipal Transportation Agency (SFMTA) Board on December 6, 2022. This corridor had initially been implemented as a COVID-19 Response Slow Street.

    Learn more about the Slow Streets Program

    Cabrillo Slow Street Evaluation

    Following the SFMTA Board’s approval of Cabrillo Street, the SFMTA Project team collected additional data analysis to assess how the street is performing against the Slow Streets Program targets:

    • Vehicle speeds at or below 15 mph
    • Vehicle volumes less than 1,000 per day

    Cabrillo Street does meet the program vehicle speed target, but does not meet the vehicle volume target.

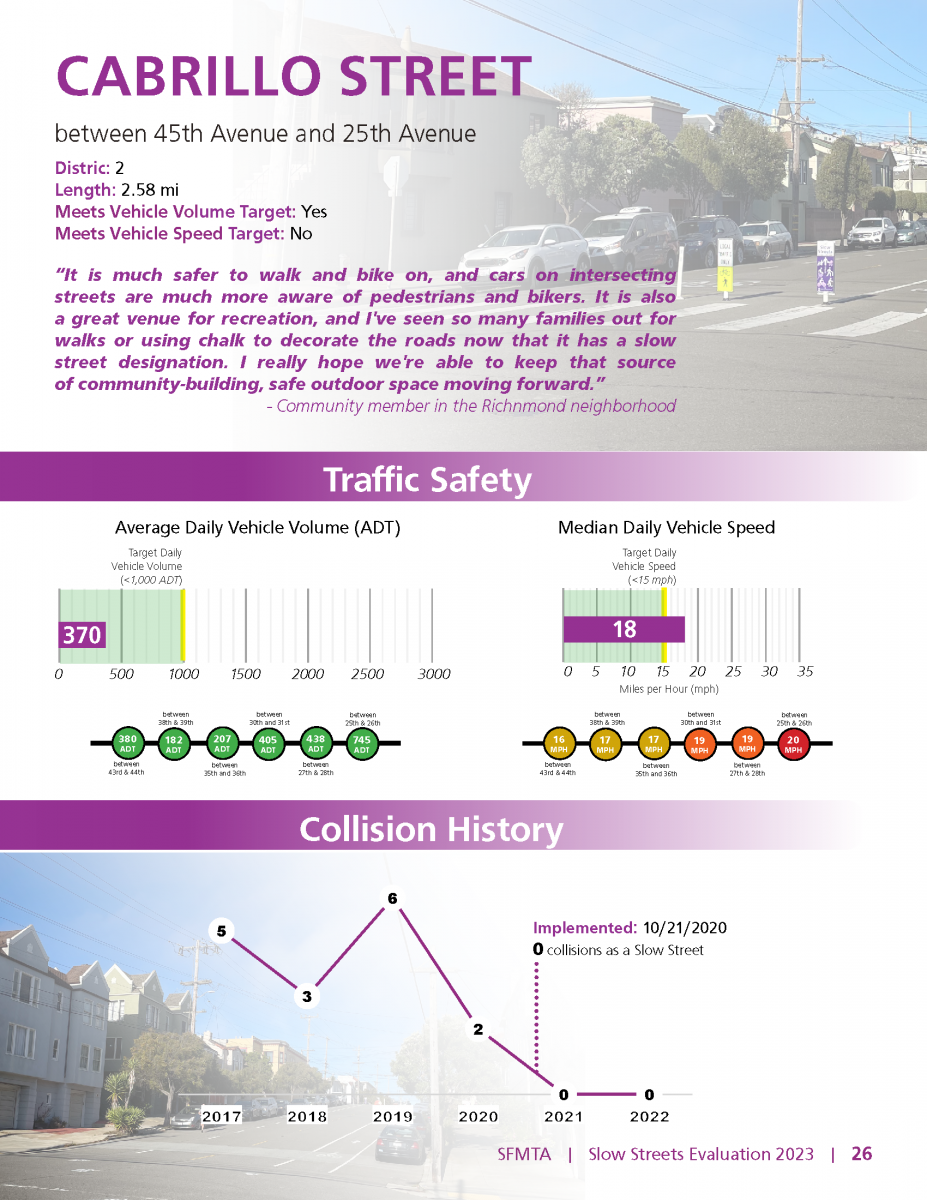

    For additional information on how this street compares to others in the Slow Streets program, or for overall program findings, please see the 2023 Evaluation Report.

    Project Timeline
    December 2022
    Project approval
    Completed
    Winter 2023
    Data collection + evaluation
    Completed
    Spring 2023
    Design process
    Pending
    Late 2023
    Implementation
    Pending
    Project Status
    Planning
    Neighborhoods

    Next Steps

    Cabrillo Street did not meet program speed targets but did meet program volume targets. The Slow Streets program team will:

    • Consider additional traffic calming tools and prepare a design to slow vehicle traffic. The design will be posted on this page and a public hearing will provide an opportunity for feedback.
    • Continue to monitor vehicle volumes on this street.

    Questions? Please reach out to the project team at SlowStreets@SFMTA.com and include "Cabrillo Street" in the subject line. To receive updates, please sign up via the link on the righthand side of this page.
